SITUATION
The Victorian Civil and Administrative Tribunal (VCAT) is a tribunal that hears and decides civil and administrative legal cases in Victoria. Established in 1998, VCAT is the busiest tribunal in Australia and finalises more than 85,000 cases a year. The president of VCAT is a judge of the Supreme Court of Victoria and 13 judges from the County Court of Victoria serve as VCAT’s vice presidents.

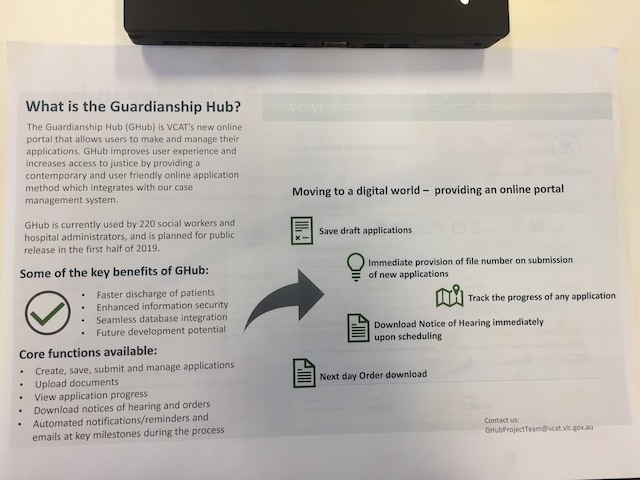

VCAT offers assessable justice to the Victorian public. VCAT does this in a timely, cost, effective and efficient way by adopting new digital solutions, one of which is the Guardianship Hub (GHub). GHub allows users (the public) to make and track applications, upload documents, receive notices of hearing etc. It also creates efficiencies for VCAT by integrating the applications and keeping all the documents in one place. GHub v1.0 was a limited release to social workers and hospital coordinators at 6 hospitals. Now a project team was working to deliver GHub v2.0 in two month’s time and needed a change manager urgently. The project team faced some push backs from some business divisions, some judges as well as some aged workers. They needed a change manager to support the change process to ensure a smooth go-live of their 2.0 digital portal.
TASK
My task was to plan, coordinate and implement hands-on change management activities across the impacted business units, focusing on effective and successful transition of individuals and teams to the new ways of working, supporting the realisation of benefits to the organisation.
I also needed to draft communications to internal and external stakeholders, as well as support and empower the GHub champions (a network of change agents), coordinate and plan training activities and build successful working relationships with internal and external stakeholders.
ACTIVITIES
Summary of Change Management Activities

(1) Change Management Planning
- I had 3 meetings with the project sponsor, the organisation’s CEO, to understand her expectations for the project outcomes, her concerns for the impacted stakeholders and to also clarify the change target. The key focus area became clear: ensure that the business was ready for go-live day.
- In parallel I organised 19 stakeholder interviews with impacted directors, managers, staff, supporting functions such as PMO, finance and communication and also with the project team to understand their views on the change, its impact to their business and their change readiness levels

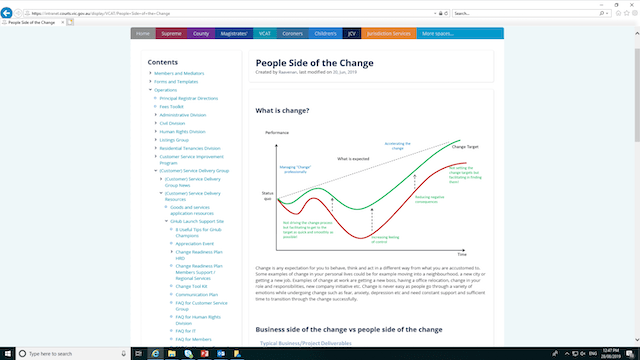

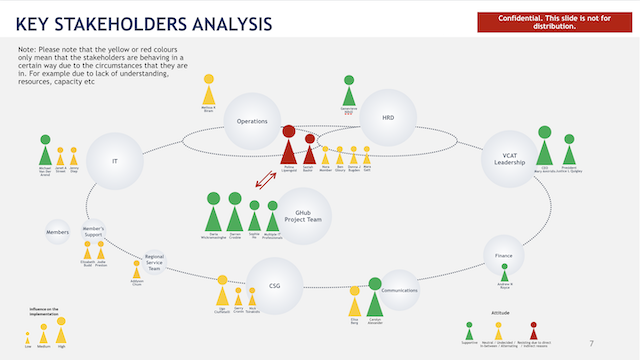

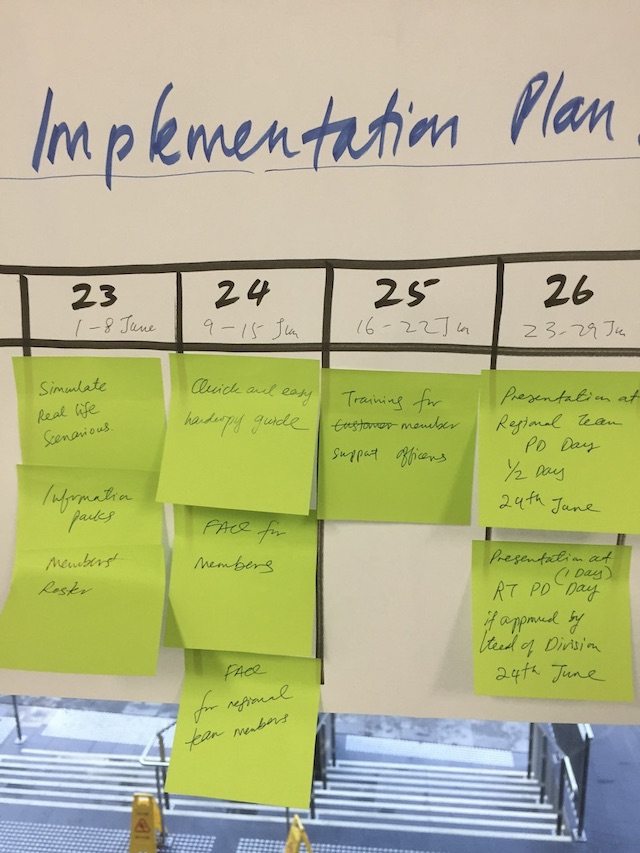

- I then organised two 2-hour mini-workshops with the project team to finalise a change impact assessment, a stakeholder analysis, a commitment curve and brainstormed a set of change activities and moulded them into a change management plan (see photos above), which I further aligned with the CEO separately.

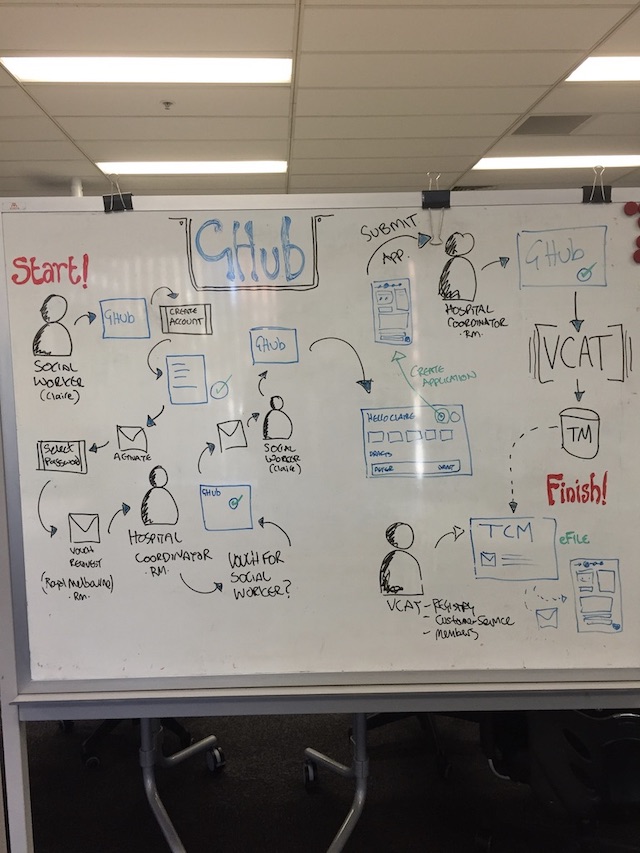

- I utilised LEGO blocks to brainstorm the change activities with various stakeholders and displayed the final version outside the CEO’s office as a display model of the change process (see photos below).
(2) Change Communication
- I organised a 2-hours mini workshop with the organisation’s communication function to understand their internal and external communication strategies and activities to support the project.

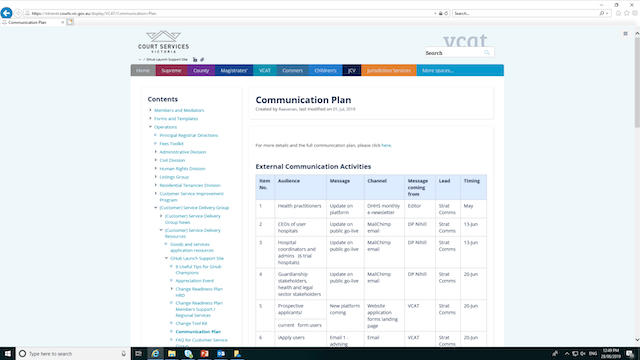

- From there I realised that more support was needed for internal communication and thus developed a change communication plan (see photos above) which I aligned with communication, the project team and the CEO
- The change communication plan had the following elements which I personally wrote and built:
- Set of key internal change messages for the CEO

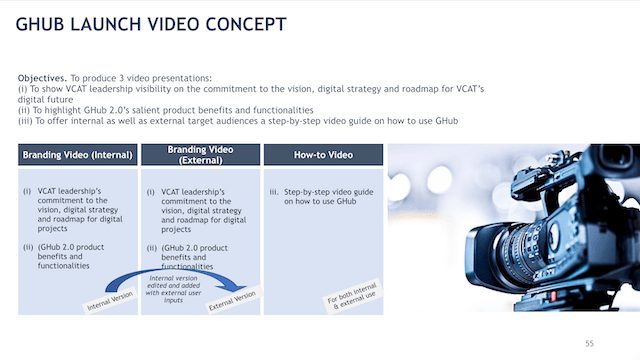

- List of recommendations to the communication function on change communication including a concept to produce 3 videos

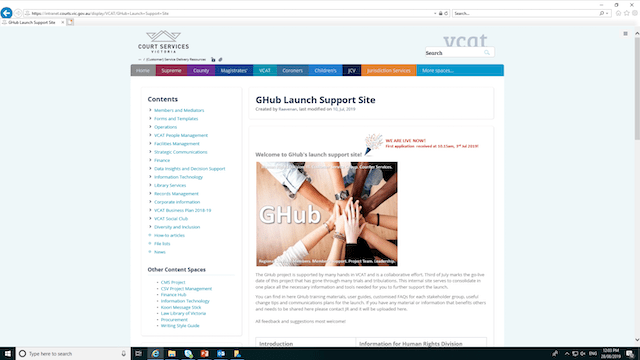

- A Confluence launch support website (see photos below) with dedicated space and FAQ for each stakeholder group
(3) Change Activities

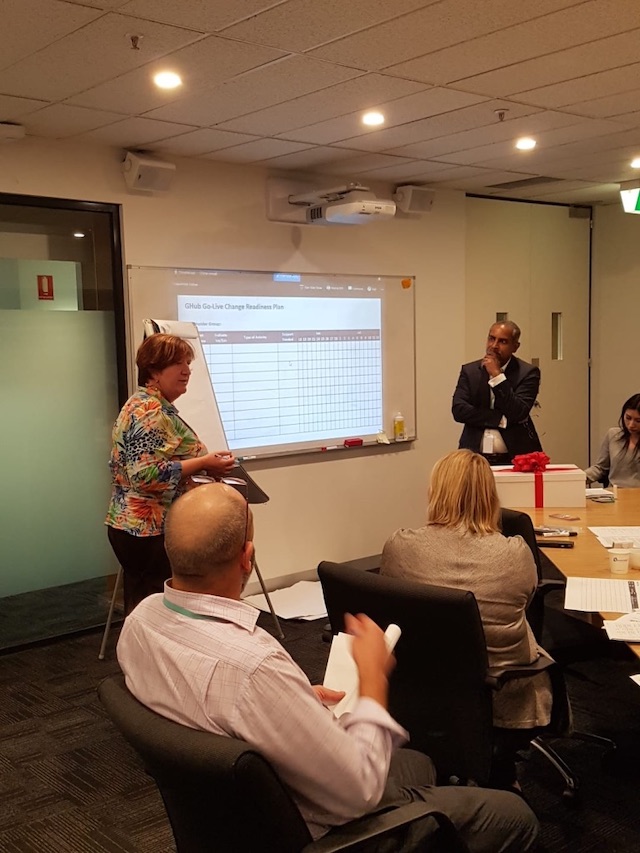

- I organised a half-day change readiness workshop (see photos above) for 27 stakeholders to built and strengthen their change readiness and leveraged the following tools in the workshop which I developed myself:
- A case study about a customer call centre’s change project which failed
- A change readiness self-assessment tool which participants use to assess themselves
- A change readiness action planning template to give a structure and timeline for planning

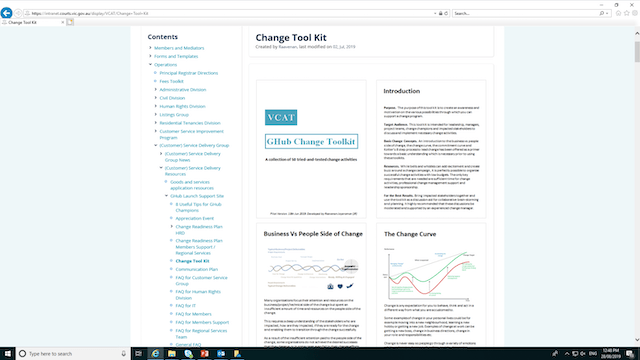

- An easy to use change tool kit with 50 change activities that I have used before
- I further followed up on the change readiness workshop with 5 change interventions with 4 impacted stakeholders to ensure that their change readiness plans were completed and implemented.
- I offered change management status updates in 4 management and PMO meetings in which I escalated potential risks and requested management for further support
- I initiated a small appreciation event (see photos below) for the project team on Go-Live Day and helped them to mark the occasion with a cake, coffee and some fun group photo taking.

(4) Lessons Learnt
- I developed and organised lessons learnt discussion activities which consisted of:

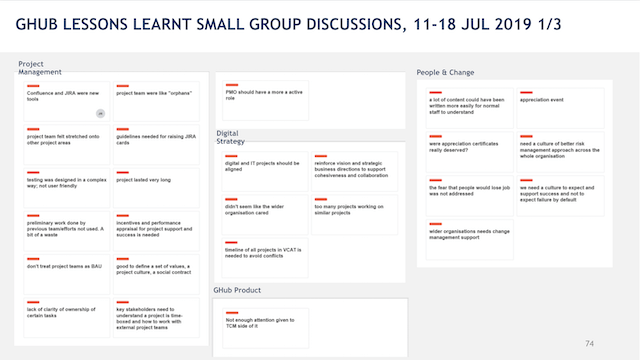

- 5 lessons learnt small group discussions with HRD, IT and Project Team

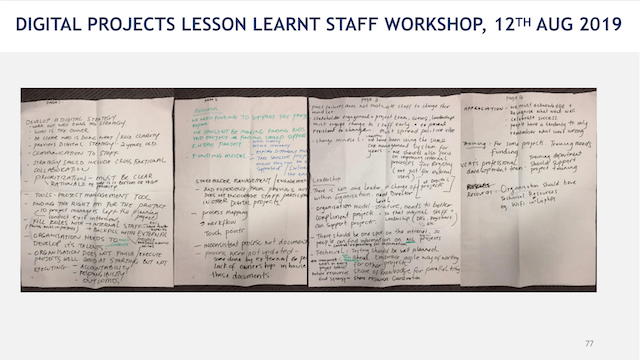

- 3 lessons learnt workshops (see photos above) with managers and staff, developers and directors

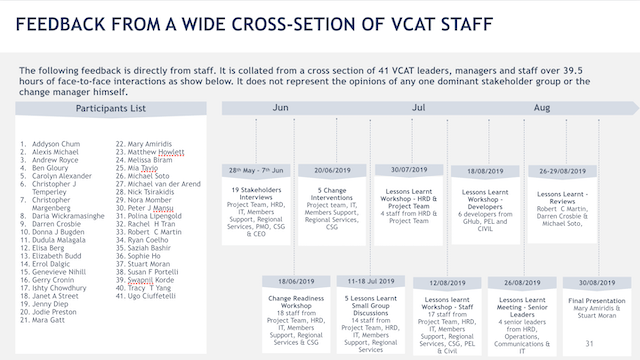

- I consolidated all the feedback and recommendations for next steps into a final report, held 2 review sessions with the project team to discuss it and finally presented the 109-slide final report to the CEO and the Strategic Advisor
(5) Appreciation
- I lobbied to organise an appreciation event to thank the impacted staff and the project team for their a good job done and was successful with a budget from the project team.
- I drafted an event program, sent out invitations, produced certificates of appreciation, delegated catering and event hosting to organise an appreciation event (see photos above).
RESULTS
GHub 2.0 was launched successfully to the public on go-live day as planned without IT issues or customer complaints. The new digital portal received its first VCAT application successfully, also being an interstate one, on go-live day. The success on the go-live day can be attributed to the following change management measures:
- Sense of urgency. Since the timeframe for change management activities was only 2 months, I developed and leveraged a strong sense of urgency to drive change towards a successful go-live day. The change readiness workshop that I organised was especially useful to help stakeholders focus and manage priority risks in a very short amount of time.
- Staff morale and motivation. I also offered moral support and motivation to the project leader and the team during the 2 months running up to the go-live day. Even though I was seen as a member of the project team, I still managed to built trust and mutual respect with the impacted stakeholders within a short amount of time. The appreciation event that I organised celebrated not only the project’s success but also the organisation’s change maturity while the lessons learnt workshops offered essential next steps for improvements.
- Transparent communication. The launch support website that I designed and built was simple but offered a one-stop information source for the staff. Everything they needed to know was all in one assessable place. It was written in plain language without IT jargon, offered customised FAQs for each impacted stakeholder group and also carried user guides, videos, charts, change tips and useful links and attracted hundreds of visits in the preceding days before the go-live day.
